It moved at night, and slowly.

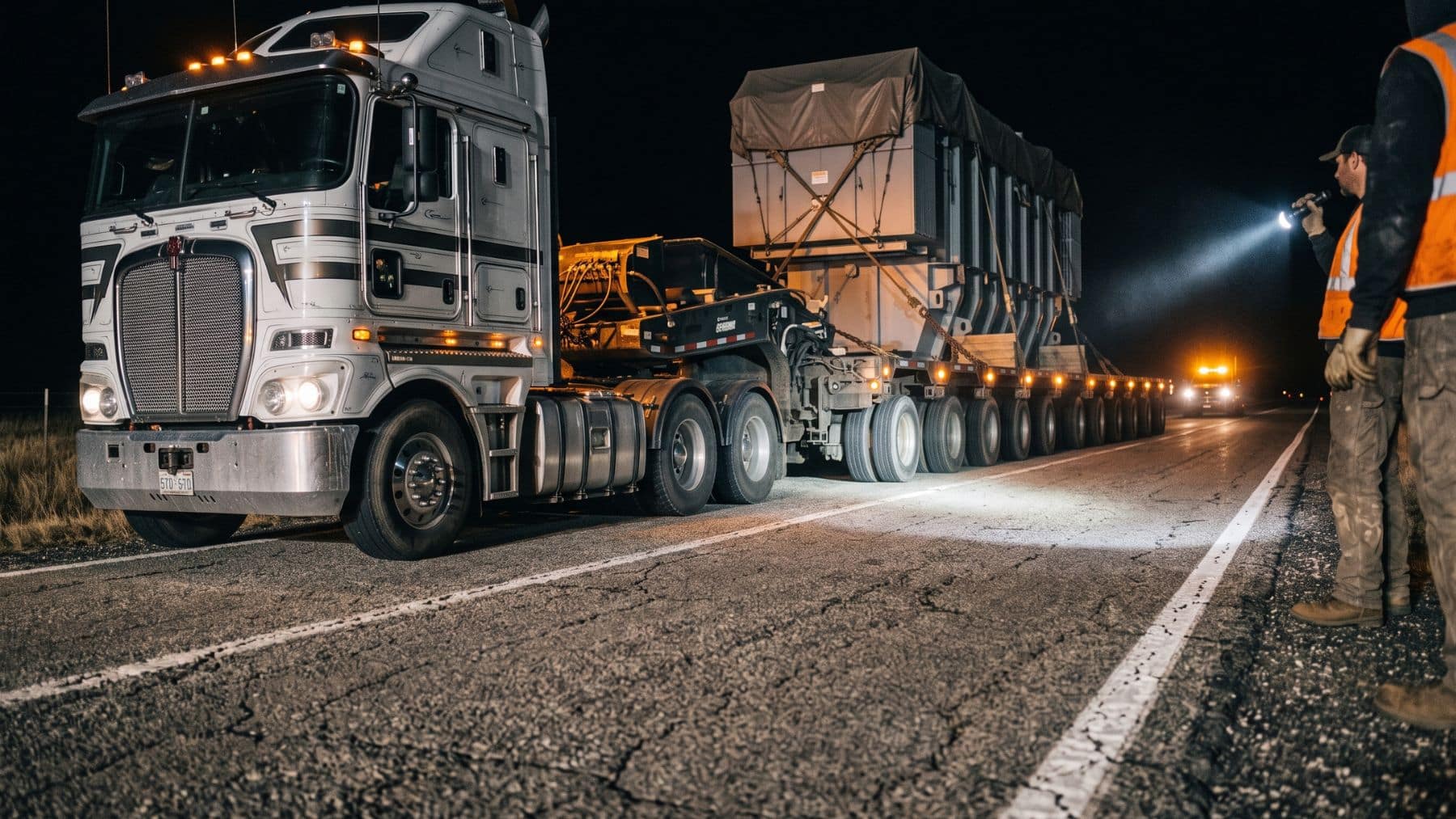

A rural highway in south central Washington, closed to everything else, with escort vehicles ahead and behind and a crew walking beside the tires watching for anything unusual.
The cargo was a single object.
Grey, boxy, 18 feet wide, worth about 2.6 million dollars and destined for a substation in the hills east of a small town.
Underneath it was the actual achievement.
A steel spine long enough to span most of a city block, riding on 48 axles, which is the reason any of this was legal.
Why the trailer is the engineering
Pavement and bridges fail in different ways.
Asphalt cares about how many pounds press down through each tire patch, so the fix there is arithmetic. Add axles, divide the same weight into smaller shares.
A bridge asks a different question.
What matters on a span is how much weight is sitting inside that span at any one moment, which is a function of how far the load is spread along the road rather than how many wheels are under it.
So length is the lever.
Stretch the same object across a trailer 360 feet long and a short bridge never carries the whole thing, because the front of the rig is off the far end before the back has climbed on.
The rig that carried it
The transformer weighed 460,000 pounds.
The trailer under it weighed 484,000, which means more than half of what rolled down that highway was the machine hired to carry the cargo rather than the cargo.
Combined, the thing came to 944,800 pounds.
Three tractors handled it, one pulling and two pushing from behind, with a fourth truck loaded with concrete blocks brought along purely for extra traction.
It was not as slow as people assume.
The rig ran at about 15 miles an hour, including stretches at six percent grade, and dropped to walking speed only for the turns past 90 degrees.
The route and what it cost to prepare
Forty seven miles, in a rough U shape, on a state route and a federal highway through Klickitat County.
It started at a rail siding and finished at a substation about 17 miles east of Goldendale, over two nights in late September.
The road did not arrive ready.
One gravel section had to be widened from 16 feet to 20, and the grade at the railhead was cut from 16 percent to 15 before anything could climb it.
The bridges got their own treatment.
Crews ran the spans using hydraulic dollies to keep the load spread and level, and accounts of the trip differ on whether two or three bridges were involved.
The tightest point was not a bridge
It was 14 miles of ordinary county road.
Twenty feet wide, with an 18 foot load on it, which leaves exactly a foot of asphalt on either side of the trailer for the entire distance.
The operations chief called it hair raising.
That is the part no permit can engineer away, because a span can be checked with a calculator and a narrow road can only be driven one foot at a time.
The axle count was not really about the bridges either.
The company’s own sales director said the 48 axle configuration was chosen because the subgrade under that state route is not especially good, meaning the roadbed rather than the spans drove the design.
Margins that thin go wrong regularly, as one flatbed proved by striking an Alaskan overpass while sitting one inch under its permitted height.
What the trip says about the grid
Moving it cost about 400,000 dollars.
That is roughly 8,500 dollars a mile to carry a piece of equipment 47 miles, and the transport bill came to about a sixth of what the equipment itself cost.
Washington is not short of these jobs.
The state issues something like 600 to 700 superload permits every year, covering anything whose combined weight passes 200,000 pounds.
The reason they matter is replacement time.
Analysts now put lead times on the largest units at up to four years, and prices have climbed roughly 80 percent across the last five.
Much of that capacity sits abroad.
Domestic production is constrained and utilities lean on imports to cover the gap, which puts an ocean crossing in front of a delivery that already ends in a 47 mile crawl.
Which turns every one of these crawls into a single point of failure.
Specialist trailers are the quiet answer to that, the same way a low steel deck is what really matters when a 90 ton digger is moved at walking pace.
The spans held, and nobody watching learned anything from that.
What the night actually demonstrated is that a power transformer is easy to build and hard to deliver, and that the hard part is finished long before an engine starts.
